Salesforce Release Dates and Schedule: Winter '27 and Spring '27
Salesforce release dates depend on your instance. Winter '27 production planning dates are September 4, October 2 and October 9, 2026, in Pacific time. The ForceFolks Salesforce Release Calendar includes sourced milestones and scheduled Spring '27 examples from Salesforce Trust. Check your instance before setting a deployment or maintenance window.
. Official release and Trust sources checked October 6, 2026. This planning calendar is not a live instance-status service.

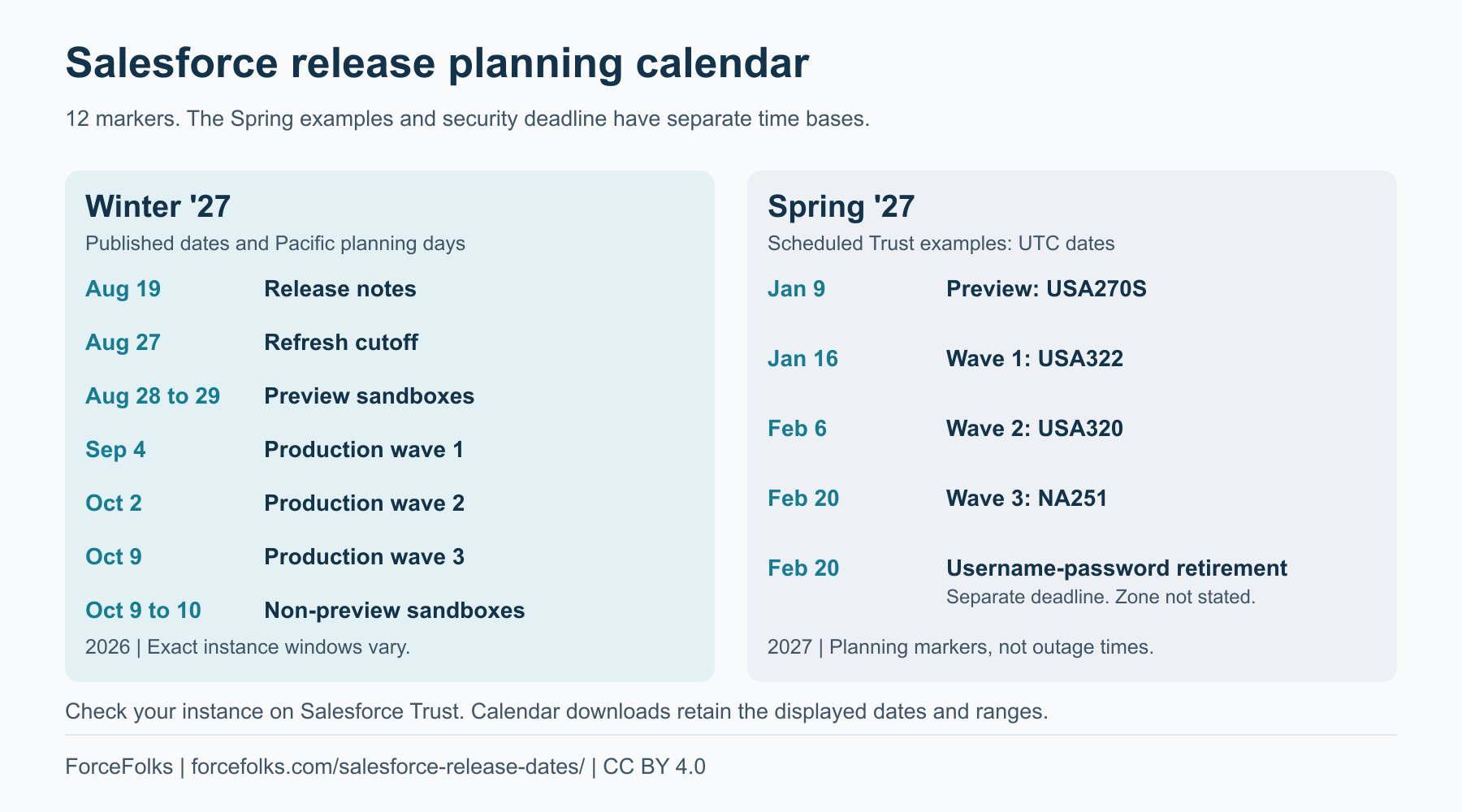

Salesforce release dates at a glance
- Major platform releases
- 3 each year: Spring, Summer and Winter.
- Winter '27 release notes
- August 19, 2026.
- Winter '27 sandbox preview
- August 28 to 29, 2026, by instance.
- Winter '27 production planning days
- September 4, October 2 and October 9, 2026, Pacific time.
- Winter '27 non-preview sandboxes
- October 9 to 10, 2026, by instance.
- Spring '27 production examples
- January 16, February 6 and February 20, 2027, in UTC. Scheduled on Trust.
- Calendar scope
- 12 planning markers. All-day entries, not exact outage windows.
Salesforce Winter '27 release dates
Salesforce's official countdown lists the 3 Winter '27 production release days. The exact maintenance window depends on your instance. Salesforce Help also lists 2-day sandbox upgrade ranges. The table keeps those ranges instead of assigning every sandbox the same day.
| Milestone | Dates and time basis | Status and limits | Official source | Calendar |
|---|---|---|---|---|
| Release notes published | August 19, 2026 Published calendar date | Confirmed Official release countdown. | Admin Release Countdown: Winter '27 Checked October 6, 2026 | Add Release notes published to Google Calendar |
| Sandbox refresh cutoff date | August 27, 2026 Pacific planning day | Confirmed Refresh must finish before the cutoff. Help specifies 6 p.m. PT. The countdown heading says before 5 p.m. PT. | Salesforce Sandbox Preview Instructions Checked October 6, 2026 | Add Sandbox refresh cutoff date to Google Calendar |
| Preview sandbox upgrades | August 28 to 29, 2026 Published calendar dates | Confirmed Exact window depends on the sandbox instance. | Salesforce Sandbox Preview Instructions Checked October 6, 2026 | Add Preview sandbox upgrades to Google Calendar |
| Production wave 1 planning day | September 4, 2026 Pacific planning day | Confirmed Check your instance on Salesforce Trust. | Admin Release Countdown: Winter '27 Checked October 6, 2026 | Add Production wave 1 planning day to Google Calendar |
| Production wave 2 planning day | October 2, 2026 Pacific planning day | Confirmed Check your instance on Salesforce Trust. | Admin Release Countdown: Winter '27 Checked October 6, 2026 | Add Production wave 2 planning day to Google Calendar |
| Production wave 3 planning day | October 9, 2026 Pacific planning day | Confirmed Check your instance on Salesforce Trust. | Admin Release Countdown: Winter '27 Checked October 6, 2026 | Add Production wave 3 planning day to Google Calendar |
| Non-preview sandbox upgrades | October 9 to 10, 2026 Published calendar dates | Confirmed Exact window depends on the sandbox instance. | Salesforce Sandbox Preview Instructions Checked October 6, 2026 | Add Non-preview sandbox upgrades to Google Calendar |
Sources: Salesforce Winter '27 countdown and Salesforce sandbox preview instructions.
The sandbox refresh must finish before the cutoff. Starting a refresh on the cutoff date does not guarantee completion. Salesforce Help warns that a late request can produce a non-preview sandbox. Check the release type before testing or refreshing.
The countdown's heading says August 27 before 5 p.m. Pacific time. The detailed Help instructions specify a 6 p.m. cutoff that day. This calendar keeps the common date as an all-day planning marker. Use the detailed sandbox instructions for operational decisions, and allow time for the copy to complete.
Time zones can change the displayed day. For example, Trust lists the USA320 Winter '27 start as October 3 at 05:00 UTC. That is October 2 at 22:00 Pacific daylight time.
This example explains the difference without assuming every instance uses that time. See USA320 on Salesforce Trust.
Salesforce Spring '27 release date
Official Salesforce Trust records show Spring '27 preview and production windows in January and February 2027. The following rows identify a specific instance as evidence for each date. They are not a complete instance schedule.
| Milestone | Dates and time basis | Status and limits | Official source | Calendar |
|---|---|---|---|---|
| Preview sandbox example | January 9, 2027 UTC planning day | Scheduled Example instance USA270S. Future planning marker, not an org-specific maintenance appointment. Trust start: 2027-01-09 03:00:00 UTC. | Spring '27 Trust record 20163638 (USA270S) Checked October 6, 2026 | Add Preview sandbox example to Google Calendar |
| Production wave 1 example | January 16, 2027 UTC planning day | Scheduled Example instance USA322. Future planning marker, not an org-specific maintenance appointment. Trust start: 2027-01-16 05:30:00 UTC. | Spring '27 Trust record 20163800 (USA322) Checked October 6, 2026 | Add Production wave 1 example to Google Calendar |
| Production wave 2 example | February 6, 2027 UTC planning day | Scheduled Example instance USA320. Future planning marker, not an org-specific maintenance appointment. Trust start: 2027-02-06 06:00:00 UTC. | Spring '27 Trust record 20163877 (USA320) Checked October 6, 2026 | Add Production wave 2 example to Google Calendar |
| Production wave 3 example | February 20, 2027 UTC planning day | Scheduled Example instance NA251. Future planning marker, not an org-specific maintenance appointment. Trust start: 2027-02-20 06:00:00 UTC. | Spring '27 Trust record 20164210 (NA251) Checked October 6, 2026 | Add Production wave 3 example to Google Calendar |
ForceFolks labels these entries Scheduled because they are future planning windows. The underlying Trust records currently use Confirmed. The ICS feed uses TENTATIVE for these 4 Spring planning markers. Check Trust again before scheduling work because Salesforce can change maintenance windows.
The dates in this table are UTC calendar days from the cited records. We do not convert them into a universal local release date. The source record includes the exact start and end times for its named instance. Your org can use another instance and another time.
Separate security deadline: Salesforce's release notes set February 20, 2027 for retirement of the OAuth 2.0 username-password flow for Connected Apps. This is a release-update enforcement date, not another production wave. The cited note does not specify a time zone.
Review affected integrations before that date. Source: Salesforce release updates.
| Milestone | Dates and time basis | Status and limits | Official source | Calendar |
|---|---|---|---|---|
| Connected App username-password flow retirement | February 20, 2027 Time zone not specified by source | Confirmed Separate release-update enforcement deadline, not a production wave. | Winter '27 Release Updates Checked October 6, 2026 | Add Connected App username-password flow retirement to Google Calendar |
| Release | Milestone | Dates | Time basis | Status |
|---|---|---|---|---|
| Winter '27 | Release notes published | August 19, 2026 | Published calendar date | confirmed |
| Winter '27 | Sandbox refresh cutoff date | August 27, 2026 | Pacific planning day | confirmed |
| Winter '27 | Preview sandbox upgrades | August 28 to 29, 2026 | Published calendar dates | confirmed |
| Winter '27 | Production wave 1 planning day | September 4, 2026 | Pacific planning day | confirmed |
| Winter '27 | Production wave 2 planning day | October 2, 2026 | Pacific planning day | confirmed |
| Winter '27 | Production wave 3 planning day | October 9, 2026 | Pacific planning day | confirmed |
| Winter '27 | Non-preview sandbox upgrades | October 9 to 10, 2026 | Published calendar dates | confirmed |
| Spring '27 | Preview sandbox example | January 9, 2027 | UTC planning day | scheduled |
| Spring '27 | Production wave 1 example | January 16, 2027 | UTC planning day | scheduled |
| Spring '27 | Production wave 2 example | February 6, 2027 | UTC planning day | scheduled |
| Spring '27 | Production wave 3 example | February 20, 2027 | UTC planning day | scheduled |
| Spring '27 | Connected App username-password flow retirement | February 20, 2027 | Time zone not specified by source | confirmed |
How to find your Salesforce instance release date
Use your org's instance record for a deployment decision. A general release calendar is useful for planning, but it cannot establish your maintenance window.
- Open Setup in your Salesforce org.
- Find Company Information and note the instance name.
- Open Salesforce Trust Status.
- Search for that instance and open its maintenance list.
- Select the major-release record and check its start, end and time zone.
- Convert that exact window to your team's time zone.
- Recheck the record before the deployment or test session.
Salesforce's release information page directs admins to Trust for maintenance dates. Use the product-specific status page if your service is not part of the core Salesforce instance schedule.
Record the instance name with the date. Without it, a calendar entry can look precise while describing a different environment. If your org moves to another instance, check the new instance's maintenance schedule.
Salesforce release readiness checklist
Begin with the business processes that must keep working. A successful test needs a clear result, not only a completed task. Record the expected outcome and evidence for each critical process.
- Read the release notes for the products your org uses.
- Confirm which sandbox receives the preview release.
- Save sandbox-only work before any refresh.
- Test key flows, Apex code and scheduled jobs.
- Test integrations with the identities they use in production.
- Check forms, reports and permissions for important user roles.
- Review Release Updates in Setup and identify required action.
- Record failures, owners and the next test date.
- Tell users about changes that affect their daily work.
- Check errors and integration logs after the production upgrade.
Salesforce recommends using the sandbox preview period to test business processes, custom code and integrations. Use its release preparation guidance alongside your own change process. The checklist here is editorial guidance, not proof that your org is ready.
Do not treat a passing sandbox test as permission to skip production checks. Data, users and connected systems can differ between environments. Agree who can approve changes and who will respond if a critical process fails.
How many releases does Salesforce have each year?
Salesforce publishes 3 major seasonal releases: Spring, Summer and Winter. Some products also ship more frequent updates. A major release date does not describe every product update or security enforcement date. See Salesforce's release overview.
Release names and calendar years can differ. Winter '27 starts reaching production in September 2026. Use the complete release name and date when writing a test plan. Do not infer a day from the release name alone.
Release Updates can have separate deadlines. Review their current notes and the status in your org. The OAuth row in this calendar illustrates that distinction. It is not an exhaustive list of security or feature-enforcement deadlines.
For related planning, see the Salesforce implementation checklist, Salesforce admin certification guide and Salesforce events calendar. Conference dates and training dates do not determine your production upgrade window.
How ForceFolks builds the Salesforce Release Calendar
The dataset uses the official release countdown, sandbox instructions, release notes and Salesforce Trust records. Each milestone records its source and check date. Source publication or update dates are stored separately when the source exposes them.
Winter production markers use the Pacific planning days. Sandbox rows retain Salesforce's published date ranges. Spring markers use UTC dates from 4 named instance records. The OAuth retirement retains its published date without an invented time zone.
All ICS entries are all-day planning markers. Their date values match the visible tables. The end date is exclusive, as required by the calendar format.
Entries do not represent service downtime or timed appointments. A 2-day sandbox range remains 2 days in the calendar.
The feed contains 12 entries: 7 Winter milestones, 4 Spring planning examples and 1 security deadline. It does not include guessed Summer '27 dates. CSV, JSON, tables and charts derive from the same reviewed dataset.
The source checks are a snapshot from October 6, 2026. Calendar subscriptions follow your app's refresh behavior. A subscription does not make this page a live Salesforce alert service. Check the source record for current operational information.
Subscribe to the calendar
Download the 12-date planning calendar as ICS
The download is a snapshot. Add the URL as a calendar subscription to receive any later file updates.
Google Calendar links open a prefilled event. Review it before saving. They do not save events automatically.
Salesforce release dates FAQ
When is the Salesforce Winter '27 release?
The production planning days are September 4, October 2 and October 9, 2026, in Pacific time. Your exact window depends on your instance. Check its maintenance record on Salesforce Trust.
When did the Winter '27 sandbox preview start?
Salesforce lists August 28 to 29, 2026 for preview sandbox upgrades. The refresh cutoff date was August 27. The refresh needed to finish before the cutoff, not only start.
When is the Spring '27 release?
The ForceFolks calendar cites Trust production examples on January 16, February 6 and February 20, 2027, in UTC. These are scheduled planning dates, not a promise for every org. Check your own instance.
Why do Salesforce release dates differ by 1 day?
Time zones can move a maintenance window across midnight. For example, October 3, 2026 at 05:00 UTC is October 2 at 22:00 Pacific daylight time. Other instances can use different times.
How do I find my Salesforce instance release date?
Find the instance in Setup under Company Information. Search for it on Salesforce Trust Status and open the major-release maintenance record. Check both the time zone and the window.
How many Salesforce releases happen each year?
Salesforce has 3 major seasonal releases: Spring, Summer and Winter. Some products also have more frequent updates. Separate Release Updates can have their own enforcement dates.
How can I add these dates to my calendar?
Use the ForceFolks ICS download or copy its subscription URL into your calendar app. Entries are all-day planning markers. The 4 scheduled Spring examples are tentative, and subscriptions use your app's refresh behavior.
